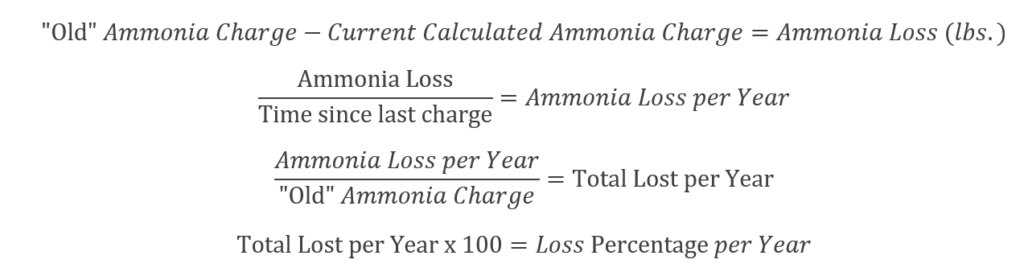

Can long Lead Times impact Process Safety?


“Time Waits for No one…”

The Issue at hand

When I first started in NH3 refrigeration, you could pick up the phone, talk to your parts-guy, and get a replacement valve quickly: often the same day, but usually within a business day or two. While you were waiting for the part, you either operated the equipment manually (requiring a temporary SOP / MOC) or shut the equipment down during the wait. We call the time between when you order something and when it arrives, lead-time.

Because lead-times *were* short, parts inventory at most facilities were kept fairly low – usually limited to what would stop production. If you could get what you needed in a day or two, why keep it on the shelf, unless you were losing 20k+ an hour in downtime?

The situation has changed around us, and I’m not sure we’ve all thought through the implications of the current supply-chain issues. Lead-times have grown substantially in 2021 and, while relief is promised in the second half of 2022, these long wait times for equipment and components have the potential to adversely affect our Process Safety.



Current Lead Time estimates

Equipment / Component Lead-Times in Weeks*
Valves, Shutoff and Control 14-24
Valves, Relief 12-20
Vessels 14-24
Condensers 14-16
Compressors 16
Air Unit / Evaporators 36
Heat Exchangers 14

*Typical for NH3 components. Varies by brand. Some halocarbons lead-times are even longer.



How can this affect Process Safety?

When you don’t have a critical spare part, and won’t have one for several months, production demands are likely to force you to operate your equipment in “temporary” modes. Here are a few thoughts:

  • Temporary is a vague term, but we don’t normally think of temporary as “weeks” or “months”. Put this in more personal terms: if your city tells you they are working on a water main and you will be without water for 8hrs, your response is quite different than if you are going to be without water for 3 months. Not having running water for a few hours means you pour some in a pitcher and delay some dish washing / bathing. Not having water for months requires an entirely different approach.
  • It is very likely that the PSM element where you “identify hazards and control them” (the PHA) was based on customary lead-times, not the ones we are now facing!
  • If operating in a temporary mode has negative safety implications, it is far easier to make the argument that we should forgo production for a few hours, or that we can handle manual operations for a few hours, than it is to justify these “temporary” arrangements for several weeks or months. As an example, if an automatic makeup feed valve to a vessel fails, it’s not terribly difficult to manually manage that for a few hour manually while your parts provider gets you the new valve. It’s far more difficult to manage that issue around the clock for several weeks or months!



What should I do?

“The first responsibility of a leader is to define reality…” –Max DePree

Well, the first step is to start a discussion with your skilled technicians and make sure they understand the environment we’re all working in. Here are some points for discussion, and further actions to take:

  • Get a good understanding of the lead-times for the replacement components in your system.
  • With that understanding, talk with your skilled technicians about what is critical for operations.
  • Discuss what you’ve learned so far with operations / production management so you can understand what they “need” and they have a better understanding of these issues.
  • Review your PHA (with all the above in mind) to see what (if any) changes you might need to make to your spare parts/equipment inventory. You might want to bias towards a higher on-site inventory, and (especially if you are using a CMMS or other parts control software) increase your “minimum” inventory to 1 or 2, rather than zero.
  • Order what you need.
  • Consider pre-writing some “temporary” SOPs for operations when failures of critical components occur.

RC&E can assist you with your parts and spares. Click Here for our Line Card. Call Dennis Vaught 817-210-1957 or email him at [email protected]

Safety Bulletin on P-Series Valves

R/S has just released a safety notification regarding the solenoid operator and LED light for the PVS and P-series valves (PA4 regulators and PS4 solenoids).



Subject: P-Series Coil Installation and Removal Notification

To properly install and remove solenoid coils on Parker P-Series products:

  • Place the solenoid coil over the solenoid operator.
  • Install the wave spring (included with the coil) over the Solenoid Operator on top of the coil.
  • Inspect the Solenoid Operator threads for damage. If the threads are damaged, the Solenoid Operator Assembly must be replaced.
  • Thread the coil retaining nut (included with the coil) or optional LED knob onto the Solenoid Operator until it contacts the wave spring. Take caution to avoid cross threading.
  • Rotate the nut or knob an additional ¼ to ½ turn, compressing the wave spring.
  • To remove the coil, unthread the coil retaining nut or the LED knob. Torque must not exceed 5 ft-lb.

If cross threading occurred or the threads were damaged, excess torque may be required for removal. This higher torque could unthread the solenoid operator from the valve leading to a refrigerant leak. If the unthreading torque exceeds 5 ft-lbs, the refrigerant in the valve must be evacuated before proceeding.

Do not open to atmosphere the valve, strainer or control until refrigerant had been evacuated. All personnel working on valves must be qualified to work on refrigeration systems. Any person intending to service a valve should read the appropriate product and safety bulletin before performing any work on R/S products.

Please pass this information on to your NH3 refrigeration operators!



You can download the safety bulletin at this link.
